Quick answer

If your UK new-build address cannot be found by broadband providers, the practical first step is to identify which stage of the registration sequence is the blocker. Stage one is Royal Mail Postcode Address File (PAF) registration; check directly at royalmail.com using your final postal address (not the construction-phase plot address). Stage two is Openreach commissioning; even after Royal Mail registration, Openreach typically takes 1 to 4 weeks to add the address to their wholesale database, then another few days to 2 weeks for major retailers (BT, Sky, EE, TalkTalk, Vodafone, Plusnet, NOW Broadband, Zen, Cuckoo) to sync. Stage three is retailer-side activation which is the quickest stage but requires both upstream stages to be complete. Practical actions in order of effectiveness. First, complete the Openreach "Get connected at a new development" form at openreach.com/connecting-new-properties; this is the single most useful tool for residents whose new-build address is not yet orderable through retailers, and it directly engages Openreach to expedite the commissioning process for your specific address. Second, contact your developer's customer care team and ask specifically whether the postal address has been registered with Royal Mail's New Build Project team and when commissioning was triggered with the network operator; reasonable developers respond constructively because they want their owners to have working broadband. Third, set up a 4G or 5G home broadband bridge for working internet during the wait; Three 5G Hub, EE 5G Smart Hub Plus, Vodafone GigaCube, or O2 Home Wireless on rolling 1-month terms deliver 100 to 300 Mbps in strong-signal urban areas with next-day setup. Fourth, where the wait extends unreasonably (more than 12 to 16 weeks for a Part R-compliant new-build with no specific complications), escalate through Ofcom, the Communications Ombudsman, or CISAS depending on which party is causing the delay. The single biggest practical mistake is signing a 24-month fixed broadband contract speculatively before your address is genuinely orderable; this can leave you paying for service that providers cannot deliver.

4 to 12 weeks
Typical UK handover gap from move-in to broadband-orderable
3 stages
Royal Mail PAF, operator commissioning, retailer sync
Get Connected
Openreach form to expedite commissioning at your address
Rolling 5G
Working internet during the wait; cancel cleanly later

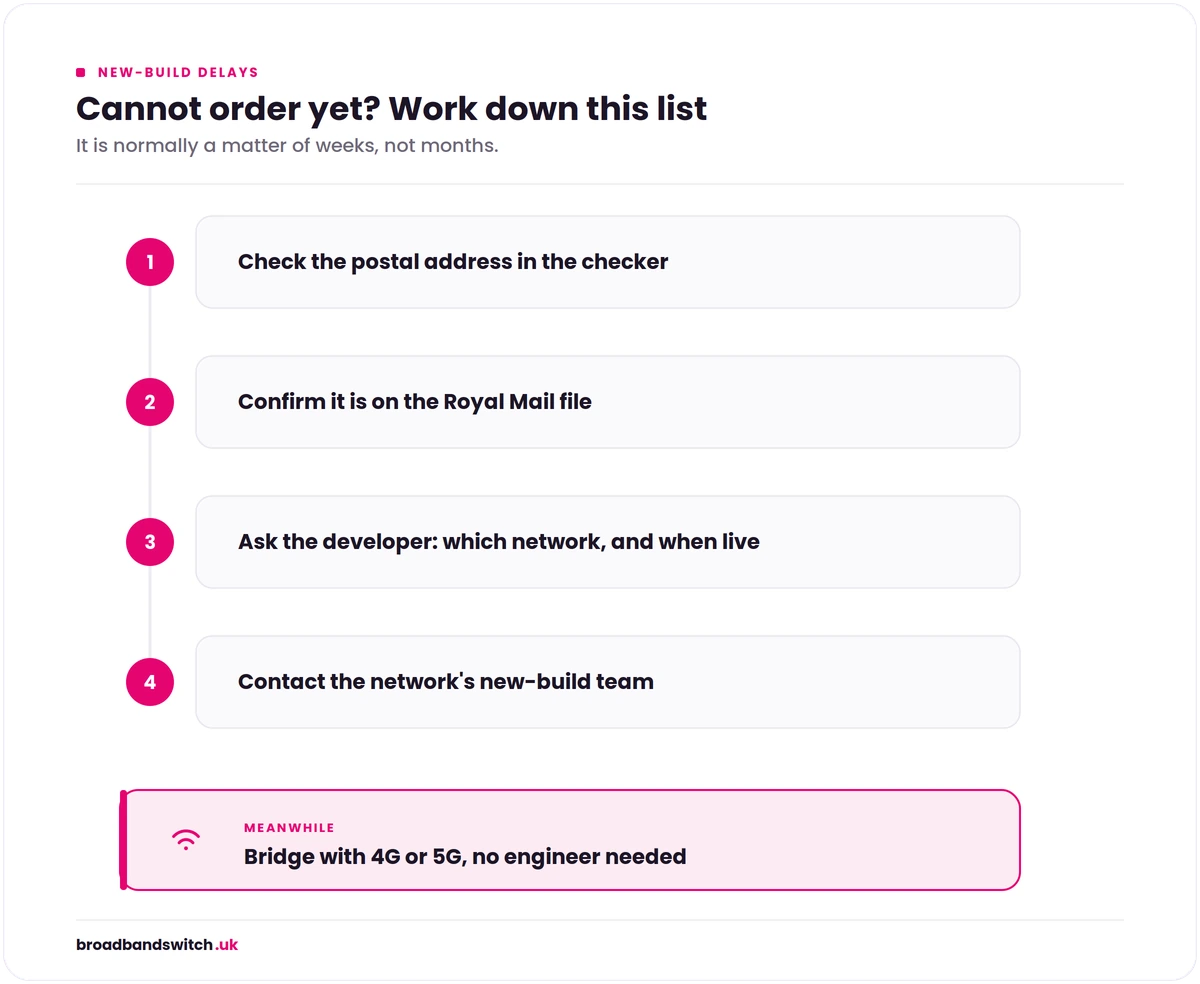

Identify the stage that is blocking you

Check Royal Mail PAF directly at royalmail.com using your postal address (not plot). If registered, the blocker is operator commissioning or retailer sync. If not registered, contact your developer.

Use the Openreach Get Connected form

The single most useful single tool: openreach.com/connecting-new-properties for new-build residents whose address is not yet orderable. Directly engages Openreach to expedite commissioning for your specific address.

4G or 5G bridge for the wait

Three 5G Hub, EE 5G Smart Hub Plus, Vodafone GigaCube, or O2 Home Wireless on rolling 1-month deliver 100 to 300 Mbps next-day in strong-signal urban areas. Cancel cleanly when fixed-line live.

Do not sign 24-month contracts speculatively

Avoid 24-month commitments before your address is genuinely orderable. If the address never goes live or is delayed beyond contract activation, you may pay for service that cannot be delivered. Wait for confirmed availability.

Postcode check

Check current availability at your new-build address

See whether your specific new-build is now orderable for FTTP, FTTC, cable, altnet, or 4G or 5G home broadband. Independent comparison from 35 plus UK retailers, refreshed multiple times daily.

See live availability at your postcode

The "address not recognised" problem in plain English

If you have moved into a UK new-build home and broadband checkers (BT, Sky, Virgin Media, Openreach, your developer-partnered altnet) cannot find your address, you are encountering one of the most common UK new-build practical problems in 2026. The good news is that this is almost always a temporary registration issue rather than a structural problem with the broadband infrastructure at your home. Most UK new-builds since 26 December 2022 have full fibre infrastructure under Building Regulations Part R; the cable is in the ground, the distribution point is in place, and the Optical Network Terminal (ONT) is often already installed at your property. What is missing is the chain of database registrations that connects your physical address to the providers' ordering systems.

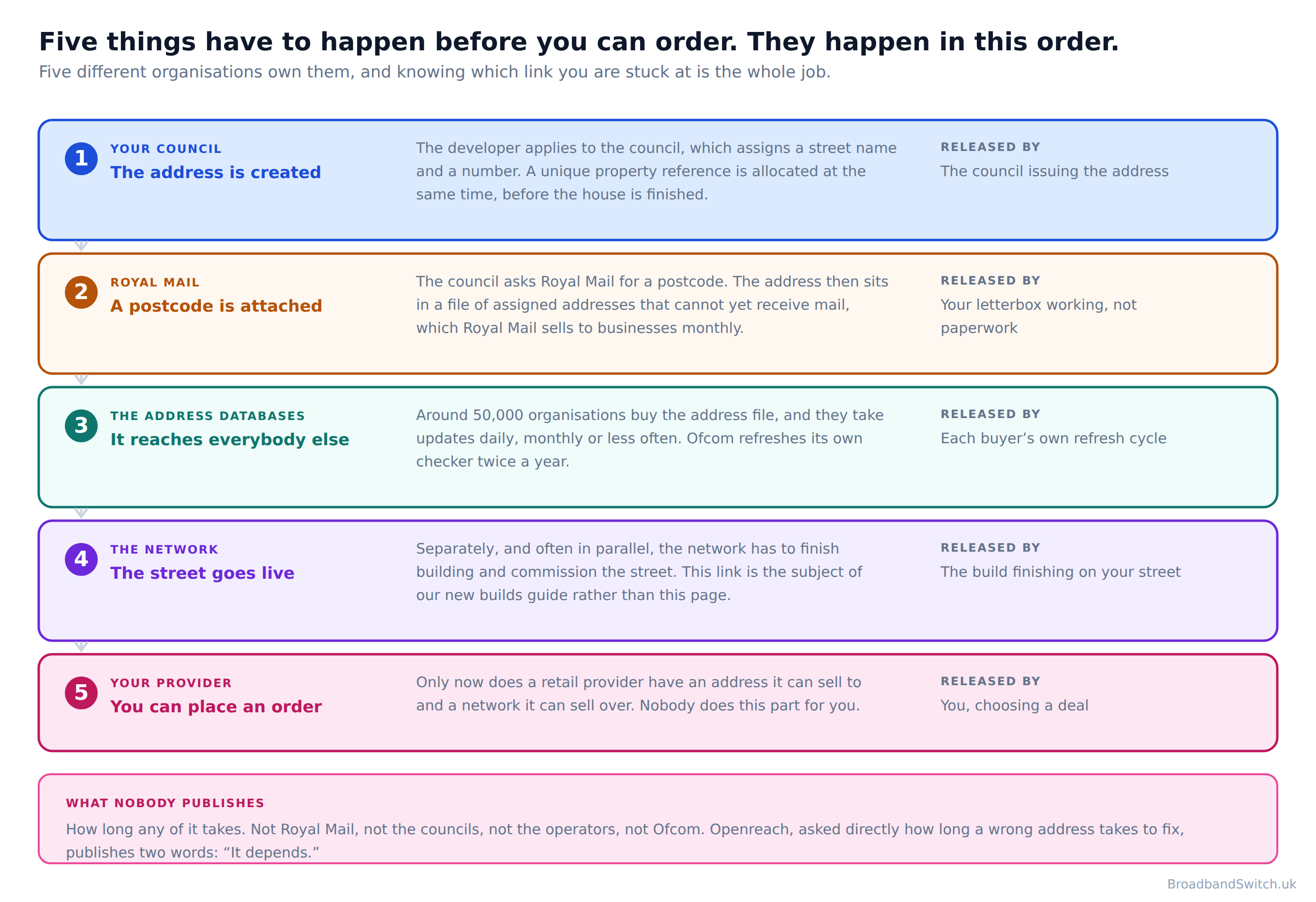

The chain of registrations that needs to complete before you can order broadband at your new-build:

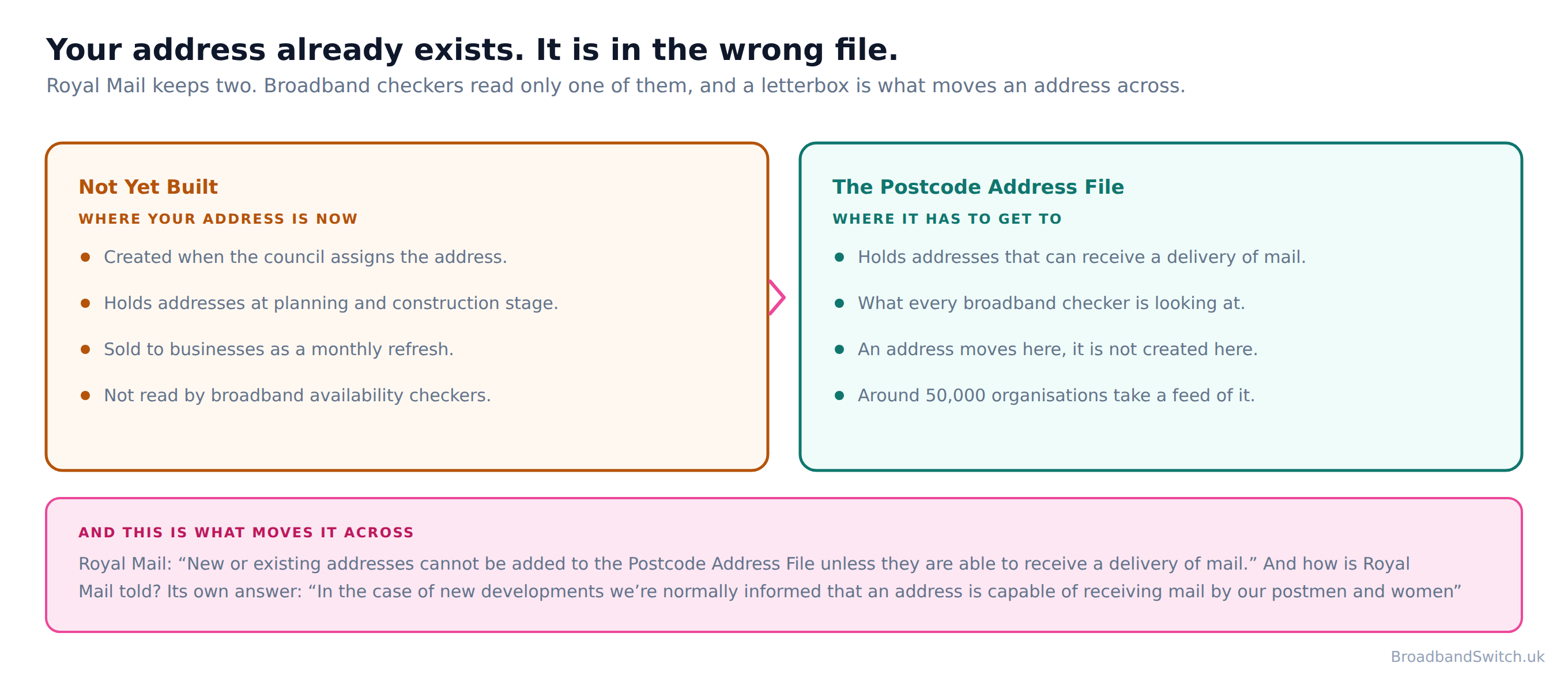

  1. Royal Mail Postcode Address File (PAF) registration. The developer submits your final postal address to Royal Mail's New Build Project team. Royal Mail processes and publishes the address in PAF. Typical timeline 1 to 4 weeks from submission.
  2. Network operator commissioning. Openreach (or Virgin Media, or your developer-partnered altnet) syncs from PAF, registers the property in their address database, tests the physical connection, and sets the property up for ordering in their wholesale system. Typical timeline 1 to 4 weeks after PAF registration.
  3. Retailer database synchronisation. Major retailers (BT, Sky, EE, TalkTalk, Vodafone, Plusnet, NOW Broadband, Zen, Cuckoo, others) sync from the network operator's database and add the new address to their order systems. Typical timeline a few days to 2 weeks after operator commissioning.

The cumulative typical timeline is 4 to 12 weeks from your physical move-in to broadband-orderable status, sometimes shorter for developments where the developer has been particularly proactive with Royal Mail and the operator, occasionally longer for smaller developments, rural new-builds, or developments where the operator commissioning has been deprioritised. When your address is not recognised, the practical question to answer first is which stage of the chain is the current blocker, because the right action varies by stage. The next three sections cover each stage and how to identify the blocker for your specific address.

One important clarifying note for new-build buyers in 2026. The "address not recognised" problem is rarely caused by a developer failing to install broadband infrastructure; under Building Regulations Part R, this is now strongly regulated. The problem is almost always a delay in one of the registration stages above. If a checker reports your address as not eligible for broadband at all (not just not recognised), that is a different problem and usually indicates a Part R compliance issue with the developer; see the developer engagement section below for next steps.

Stage one: Royal Mail Postcode Address File registration

Royal Mail's Postcode Address File (PAF) is the master UK database of postal addresses, used by virtually all UK organisations that need to verify or look up addresses including broadband providers. When a UK new-build home is completed, the developer submits the final postal address (typically formatted as "32 Beech Avenue, Newtown, [Postcode]") to Royal Mail's New Build Project team for inclusion in PAF. Until your address is in PAF, broadband providers cannot order service to it because their address validation systems will reject it.

How to check whether your address is in PAF:

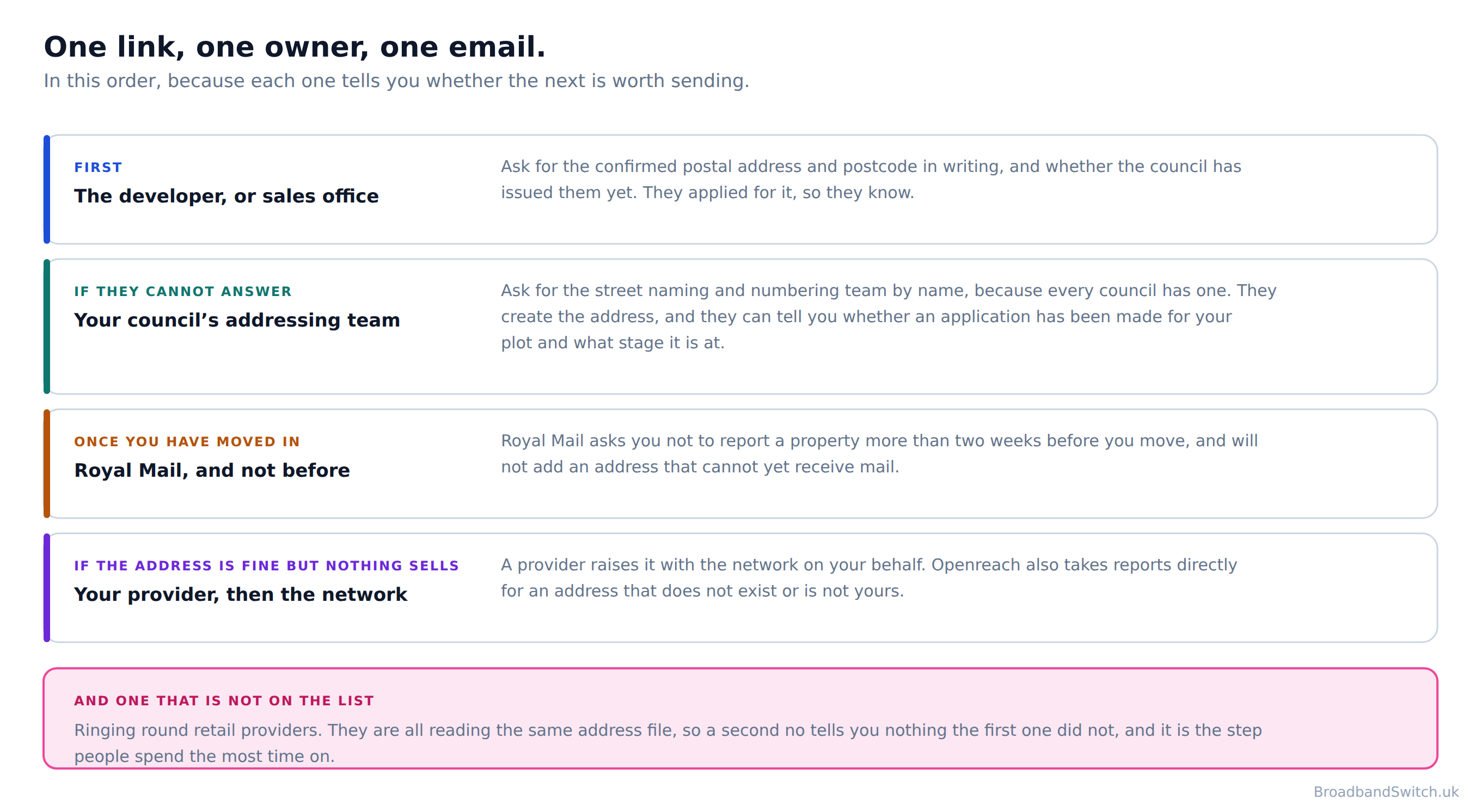

What to do if your address is not in PAF:

  1. Confirm the postal address with the developer. Ask whether the address has been submitted to Royal Mail's New Build Project team and when. Reasonable developers will tell you the submission date and the expected publication date.
  2. Confirm processing status with Royal Mail directly. Royal Mail's New Build Project team can confirm whether a developer's submission for your specific address has been received and is in processing; contact via Royal Mail's developer support pages. This is more useful than guessing.
  3. Wait the typical 1 to 4 week processing window. Royal Mail processes new addresses on a rolling basis; most new addresses appear in PAF within 1 to 4 weeks of submission. Bigger developments with batches of addresses can take slightly longer.
  4. Escalate if registration is materially delayed. If more than 4 weeks have passed since the developer submission and your address is still not in PAF, ask the developer to follow up with Royal Mail. Where the developer is unresponsive, Citizens Advice can provide guidance on consumer rights for new-build buyers.

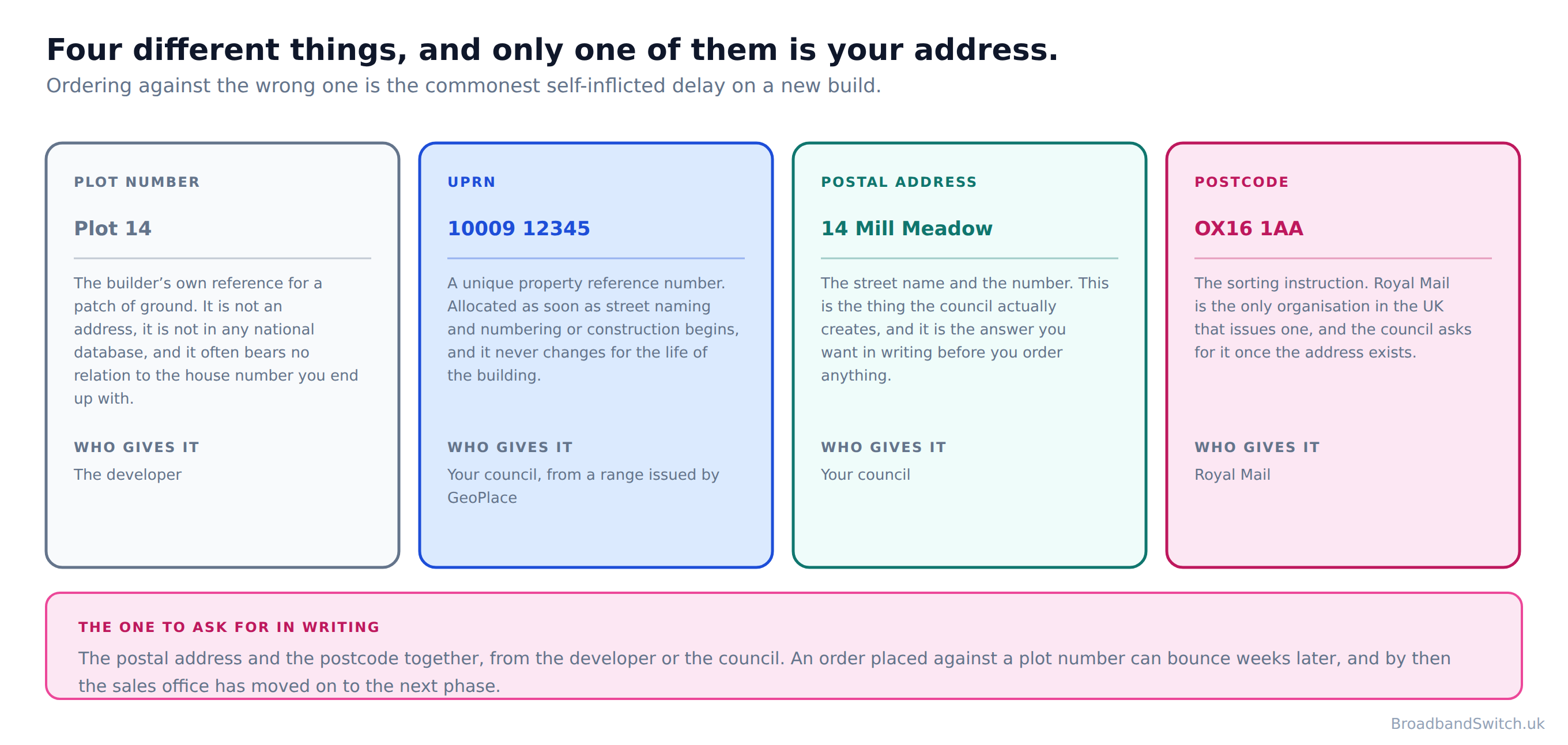

One important note on plot vs postal address. Many new-build buyers spend weeks searching broadband checkers using their plot address (the construction-phase identifier "Plot 47, Phase 2, [Development Name]") and conclude that broadband is unavailable when actually the postal address has been registered correctly but they have been searching with the wrong identifier. Always use the postal address with broadband checkers; the plot address is only used during construction and will not be recognised by any broadband database. See our main new-build broadband guide for detailed coverage of plot-to-postal mapping.

Stage two: Openreach or operator commissioning

Once your postal address is registered in Royal Mail's PAF, the network operator (Openreach for most UK new-builds; Virgin Media O2 in Nexfibre-served developments; your developer-partnered altnet in altnet-served developments) needs to commission your specific property: register the property in their wholesale address database, verify the physical connection from the street to your home, and set the property up for ordering. Without operator commissioning, retailers cannot offer service to your address even if Royal Mail PAF has the address registered.

How operator commissioning works for Openreach (the most common UK new-build scenario):

  1. Address sync from PAF. Openreach syncs from Royal Mail's PAF on a regular cycle and identifies new addresses that need to be commissioned. Your address appears in Openreach's "to commission" queue.
  2. Physical infrastructure verification. Openreach verifies that the physical fibre connection from the street distribution point to your specific property is in place and working. For Part R-compliant new-builds where the developer has installed Openreach FTTP infrastructure during construction, this is typically a straightforward database check; for new-builds where Openreach needs to confirm the connection independently, an engineer site visit may be needed.
  3. Database publication for ordering. Once verified, Openreach adds your address to its wholesale ordering database; this is the database that all Openreach-network retailers (BT, Sky, EE, TalkTalk, Vodafone, Plusnet, NOW Broadband, Zen, Cuckoo, others) sync from.
  4. Service-level confirmation. Openreach confirms the service levels available at your specific address (FTTP speed tiers up to 1.6 Gbps, FTTC fallback if applicable, copper-only if neither FTTP nor FTTC is available).

Typical timeline 1 to 4 weeks from PAF registration to Openreach commissioning, sometimes faster for developments with strong developer-Openreach coordination, occasionally slower for smaller developments or rural areas. How to check whether your address has been commissioned by Openreach:

What to do if your address is in PAF but not yet commissioned by Openreach:

  1. Complete the Openreach "Get connected at a new development" form. This is the single most useful tool for residents in this stage; covered in detail in the next section.
  2. Wait the typical 1 to 4 week window. Most Openreach commissioning completes within this window.
  3. Engage the developer if commissioning is materially delayed. Some commissioning delays trace back to developer-Openreach coordination issues; the developer's customer care team can sometimes nudge Openreach to expedite specific addresses.
  4. Set up a 4G or 5G bridge for working internet during the wait.

For Virgin Media Nexfibre and altnet operators, the commissioning process is structurally similar: sync from PAF, verify physical connection, publish for ordering. Each operator has their own customer service channels for addresses stuck at commissioning; contact the named operator (or your developer-partnered altnet) directly for status.

Stage three: retailer database synchronisation

Once your address is in Royal Mail's PAF and Openreach (or your network operator) has commissioned it, the final stage is retailer database synchronisation. Major broadband retailers maintain their own address databases that sync from the network operator's wholesale database; the sync is typically automatic but timing varies between retailers. Some retailers update their address databases multiple times per day, picking up new addresses as soon as Openreach commissions them; others sync less frequently (daily or weekly batch updates), which can introduce additional delay between Openreach commissioning and the retailer being able to take orders.

Typical retailer sync patterns in 2026:

The practical implication is that if some retailers can offer service to your address but others cannot, the difference is retailer sync timing rather than infrastructure availability. This is a common pattern: BT might show your address as orderable while Plusnet still shows "not eligible" because Plusnet's daily sync has not yet picked up the address. A few days later, Plusnet's database catches up. When this happens you can either order with the retailer that already shows availability, or wait a few more days for the retailer you prefer to sync.

Action you can take during retailer sync delays:

  1. Try multiple retailer checkers. If at least one major retailer shows your address as orderable, your infrastructure is in place; the others will catch up within days.
  2. Order with a retailer that already syncs your address. Choose 12-month no-exit-fee tariffs (Cuckoo, NOW Broadband 12-month) or rolling-month options if you may want to switch later for premium support, bundled TV, or specific features.
  3. Wait for your preferred retailer to sync. This is a reasonable choice if you have a 4G or 5G bridge already running and a few extra days does not matter.

The Openreach "Get connected at a new development" form

The Openreach "Get connected at a new development" form is the single most useful tool for UK new-build residents whose address is not yet orderable through retailers. Available at openreach.com/connecting-new-properties, the form directly engages Openreach to expedite the commissioning process for your specific address. This is genuinely valuable: rather than waiting passively for the standard sync sequence to complete, the form raises a specific case at Openreach for your address.

How to use the Openreach Get Connected form effectively:

  1. Use your final postal address (not plot address). Even if Royal Mail's PAF does not yet have the address, Openreach's New Build team can typically work with the developer-confirmed postal address if you provide it.
  2. Provide the developer's name and the development name. Openreach uses these to cross-reference with their existing developer relationships; for major UK developers (Persimmon, Taylor Wimpey, Barratt Redrow, Bellway, Berkeley Group, Crest Nicholson, Vistry, Bloor) Openreach has established communication channels.
  3. State your move-in date. Helps Openreach prioritise addresses where residents are already living without broadband vs addresses still ahead of move-in.
  4. Note any specific stage you have identified as the blocker. If you know your address is in PAF but not yet commissioned by Openreach, say so; if you know commissioning has happened but no retailer can order, that is different. Openreach's response will be more targeted with this information.
  5. Provide a working contact phone number and email. Openreach's response typically comes within 5 to 10 working days; faster for clearly-defined cases.

What Openreach typically does in response. For straightforward cases (address simply waiting for the next standard sync cycle), Openreach acknowledges and the address typically appears in retailer systems within 1 to 2 weeks of the form submission. For cases where there is a specific commissioning blocker (developer registration issue, physical connection verification needed, specific Openreach process delay), Openreach engages with the developer or with their internal teams to resolve and provides updates. For cases that have been waiting unreasonably long (more than 12 to 16 weeks for Part R-compliant new-builds), Openreach typically prioritises and provides an expected resolution date.

The Get Connected form is also useful for new-build residents who are stuck on FTTC where FTTP should be available under Part R. In this scenario, the form prompts Openreach to verify the FTTP infrastructure status at your specific address; sometimes the FTTP commissioning has been deprioritised or missed despite the developer having installed the infrastructure, and the form prompts Openreach to complete the missing steps.

Openreach "Build It and Connect It" for self-builders

If you are a self-builder or custom-builder facing a broadband delay (not a buyer in a developer-led estate), the relevant Openreach process is "Build It and Connect It" rather than the Get Connected form. Available at openreach.com/connecting-new-properties, this is the process Openreach offers to individual self-builders for FTTP infrastructure to a single new property or small handful of new properties.

The "Build It and Connect It" process:

For self-builders facing broadband delays after construction completion, the "Build It and Connect It" team at Openreach is the right contact. Contact via the form at openreach.com/connecting-new-properties stating the property is a self-build (or custom-build) and providing the build completion date. Openreach will assess and confirm the next steps; for most self-builds in serviced areas with Part R-compliant infrastructure, this is straightforward. For self-builds in rural areas without standard Openreach FTTP availability, regional altnets (Gigaclear, Truespeed, Connect Fibre, Quickline, Fibrus, Ogi) are often the practical alternative; some have their own equivalents to "Build It and Connect It" for individual customers.

Engaging with your developer's customer care

Most major UK developers have customer care teams that handle post-completion issues including broadband delays. Reasonable developers respond constructively to broadband concerns because they want their owners to have working homes; broadband is a genuine quality-of-life issue and developers know it affects buyer satisfaction and word-of-mouth reputation. Engaging with the developer's customer care is genuinely useful for many delay scenarios.

When developer engagement is most useful:

When developer engagement is less likely to help:

The practical sequence for engaging a major UK developer's customer care. First, check the developer's published customer care channels: most major UK developers have dedicated customer service phone numbers, email addresses, and online portals for post-completion issues. Second, contact in writing rather than by phone where possible; written communication creates the documented record. Third, provide specific details (your property address, move-in date, the specific problem you are experiencing, what you have already tried). Fourth, ask specifically about the registration sequence stages: when was the postal address submitted to Royal Mail; when was network operator commissioning triggered; has the development been fully handed over to the operator. Fifth, request a specific response date or update timeline; this creates a clear escalation point if the developer is unresponsive.

What to ask the developer specifically

The right questions get useful answers; vague concerns get vague responses. Specific questions to ask your developer's customer care team about a broadband delay at your new-build:

  1. "When was my postal address submitted to Royal Mail's New Build Project team?" If submitted recently, you are at the start of the registration sequence and the typical 4 to 12 week timeline is in progress. If submitted weeks ago and PAF still does not have the address, the developer can chase Royal Mail.
  2. "Is my development fully handed over to Openreach (or the named network operator) for commissioning?" Some developments hand over to operators in phases; if your specific phase is not yet handed over, broadband is structurally not yet available. The developer can confirm phase handover status.
  3. "Has the developer confirmed completion of my specific plot to Openreach?" Openreach typically commissions individual plots once the developer confirms completion to them; if completion has not been confirmed, commissioning is blocked at the developer end.
  4. "Which specific broadband providers has the developer partnered with for this development?" This confirms which operators and retailers should ultimately serve your home; some developments have multiple partnerships giving you choice once commissioning completes.
  5. "Has the development passed Building Regulations Part R compliance for broadband infrastructure?" Confirms that the broadband cabling and ducting required by Part R has been installed and verified at your specific home.
  6. "What is the typical handover gap that previous buyers in this development have experienced?" Provides a benchmark for whether your specific delay is within or beyond typical patterns for this development.
  7. "What is the developer's process for escalating broadband delays beyond typical timelines?" Establishes whether the developer has a defined escalation process and gives you a clear next step if the standard timeline is exceeded.

What useful answers look like. A reasonable developer customer care team will be able to answer most of these questions or commit to coming back to you with answers within a working week. An evasive or unresponsive customer care team is itself a yellow flag; if you cannot get clear answers to specific factual questions about the registration sequence, escalation through Citizens Advice, the Communications Ombudsman, or the relevant industry body becomes more relevant.

Templates for developer correspondence

Below is a standard template for a UK new-build buyer writing to their developer's customer care team about a broadband delay. Adapt to your specific situation.

Template letter: new-build buyer to developer customer care

[Your name]
[Your new-build postal address]
[Your move-in date]
[Date of letter]

Dear [developer customer care team name],

Re: Broadband connectivity delay at [your specific address]

I am writing about a broadband connectivity issue at my new-build home at the address above. I moved in on [date] and have been unable to order broadband from any major retailer because my address is not yet recognised in the broadband providers' ordering systems. I have checked using my final postal address (not the construction-phase plot address) on BT, Sky, EE, and TalkTalk's checkers; all return "address not eligible" or similar responses.

I have checked the address on Royal Mail's PAF finder at royalmail.com [insert finding: registered, or not yet found]. I have completed the Openreach "Get connected at a new development" form on [date] [insert any response received].

As you will appreciate, broadband is essential for my household for [include specific reasons relevant to you: home working, online learning, smart home devices, security systems, digital voice phone service, etc]. The delay is materially affecting my household's quality of life.

I would appreciate your written response to the following specific questions:

1. When was my postal address submitted to Royal Mail's New Build Project team?

2. Is my development fully handed over to Openreach (or the named network operator) for commissioning?

3. Has the developer confirmed completion of my specific plot to the network operator?

4. Which specific broadband providers has the developer partnered with for this development?

5. Has the development passed Building Regulations Part R compliance for broadband infrastructure?

6. What is the typical handover gap that previous buyers in this development have experienced?

7. What is the developer's escalation process for broadband delays beyond typical timelines?

I would appreciate a written response within 14 working days. If the issues raised cannot be resolved through your customer care team, I will need to consider escalation through Citizens Advice, the Communications Ombudsman, or relevant regulatory bodies as appropriate.

Thank you for your attention to this matter.

Yours sincerely,
[Your name]
[Phone or email contact]

Practical notes on using this template. First, adapt the specifics to your situation: your address, your move-in date, your specific household impact. Second, send by recorded post or email with read receipt; this creates documented timeline supporting any later escalation. Third, keep the tone factual and specific; vague complaints get vague responses, specific factual questions tend to get specific factual answers. Fourth, give the developer reasonable time (14 working days is a standard expectation) before escalating further. Fifth, document any responses you receive; the cumulative correspondence record is what matters if you later need to escalate to Ofcom, the Communications Ombudsman, or CISAS.

4G and 5G bridge options for immediate use

The single most useful practical action for UK new-build residents stuck in a broadband delay is to set up a 4G or 5G home broadband bridge for working internet during the wait. The 2026 UK options are mature, fast, and cancellable on rolling-month terms which makes them ideal for filling the handover gap.

Provider Product Typical speed Practical note for new-build delays
Three Home5G Hub on rolling 1-month100 to 300 Mbps in strong-signal urban areasStrongest UK 5G coverage in major cities; rolling-month flexibility; cancel cleanly when fixed line live
EE Home5G Smart Hub Plus on rolling 1-month100 to 500 Mbps in 5G areasExcellent 5G coverage post-VodafoneThree merger May 2025; EE remains separate brand within BT Group
VodafoneGigaCube on rolling 1-month or 24-month50 to 200 MbpsAvailable for both 4G and 5G; rolling 1-month recommended for delay bridges
O2 Home Wireless5G or 4G on rolling50 to 300 Mbps in 5G areas; 30 to 100 Mbps on 4GUseful where Three or EE 5G coverage is weak at your specific new-build address
SmartyMobile data plans plus tethering or hotspot device50 to 200 Mbps in strong-signal areasCheapest; suitable for very short bridges (2 to 4 weeks) for single tenant or couple
iD Mobile, Lebara, VoxiUnlimited data SIM plus portable hotspot50 to 200 MbpsWorkable cheaper bridge; less polished than dedicated 5G Hub but cheaper

The practical sequence for setting up a 4G or 5G bridge:

  1. Check 5G coverage at your specific new-build address. Use Three's coverage checker at three.co.uk/coverage, EE's coverage checker, Vodafone's coverage checker, or O2's coverage checker. Coverage varies significantly by location even within the same town because new-build estates may have weaker signal than older houses 500 metres away. Where multiple operators show good coverage, choose based on rolling-month price and rental terms. Where coverage is patchy, choose the operator showing the strongest signal at your specific address.
  2. Order the 5G Hub or equivalent. Most UK 5G Hubs ship next-day or within 2 working days. Order to your new-build address directly once you have moved in, or to an alternative pickup location if you order before move-in.
  3. Set up on arrival. Plug in the 5G Hub; insert the supplied SIM (typically pre-installed); follow the operator's setup app or web portal. Most modern 5G Hubs are configured in under 15 minutes. Verify signal strength in your primary internet-use room (kitchen, living room, home office); if signal is weak, try different placement or different rooms.
  4. Cancel cleanly when fixed-line live. Rolling-month plans bill from activation and cancel from the next billing date. Ensure your fixed-line FTTP service is fully active and tested before cancelling the bridge to avoid any gap in connectivity.

One specific note on signal strength at new-build estates. New-build estates may have weaker signal than the older areas around them because the developer has built homes faster than mobile network operators upgrade local infrastructure to handle the new population density; some new-build areas have temporary signal challenges that resolve within 6 to 12 months as the operators add capacity. This means choosing the operator with the strongest signal at your specific address is important; checking with neighbours who already live in the development for their signal experience is genuinely useful.

Mobile data tethering as a short-term option

For very short broadband delays (2 to 4 weeks) or for new-build residents on tight budgets, smartphone tethering or a portable mobile hotspot is a viable lower-cost alternative to a dedicated 5G Hub. Most modern UK mobile contracts include unlimited or large data allowances that can be shared with a household via the smartphone's hotspot feature or an external 4G/5G hotspot device.

The tethering options:

The trade-offs vs a dedicated 5G Hub. Dedicated 5G Hubs offer better Wi-Fi coverage throughout the home, more simultaneous device connections, more reliable performance, and integrated home-broadband-style customer support. Tethering and portable hotspots are cheaper, more flexible, and work well for short-term very-light-use bridges. For most UK new-build residents facing a 4 to 12 week delay with a normal household (couple, small family, work-from-home, smart home devices), a dedicated 5G Hub is the better choice; for very short delays (under 4 weeks) or single-tenant scenarios, tethering can be adequate.

Cost-benefit of the bridge during the wait

The cost of a 4G or 5G home broadband bridge during a UK new-build handover gap is genuinely modest in the context of the move-in disruption. Typical 2026 UK rolling-month 5G Hub pricing:

For a typical 4 to 12 week handover gap, the cumulative cost of a 5G Hub bridge is £25 to £120 (one to three months at £25 to £40 per month). This is a modest insurance against the alternative of being offline for weeks during a move; for households with home workers, online learners, or smart-home dependence, the cost is genuinely worthwhile. Where the bridge cost is a concern, the Smarty SIM plus hotspot route at £15 to £25 per month plus one-off device cost is the cheapest reasonable option.

One important note on cancellation discipline. Rolling-month 5G Hubs bill from activation and cancel from the next billing date. Set a reminder to cancel the bridge the day after your fixed-line FTTP service is confirmed working; otherwise you may pay for an additional month after you no longer need it. Most major UK operators allow cancellation through the customer service phone line, online portal, or chat; cancellation is typically processed within 1 to 5 working days. Ensure your fixed-line service is fully tested (run a speed test, confirm Wi-Fi coverage, test specific use cases like video calls, smart home devices, work VPN) before cancelling the bridge to avoid any gap in connectivity.

Move-home contracts when address is not yet recognised

If you have an existing broadband contract at your previous address and are moving to a new-build, the standard move-home process used by most UK retailers requires the new address to be recognised in the retailer's system. When your new-build address is not yet in the retailer's system, the standard move-home process cannot complete, leaving you with three practical options.

Move-home scenario Practical option Implications
New-build address not yet recognised; existing contract has 6 plus months remainingPause or transfer the existing contract; use 4G or 5G bridge until new-build is orderableSome retailers waive ETF fees for new-build moves where service is genuinely unavailable; ask explicitly
New-build address not yet recognised; existing contract about to endLet existing contract end; use 4G or 5G bridge; sign new contract once new-build is orderableCleanest scenario; no ETF complication; rolling-month bridge gives flexibility
New-build address recognised by some retailers but not your current retailerSwitch to a retailer that recognises the address using One Touch Switch; or wait for your current retailer to syncOne Touch Switch (launched 12 September 2024) makes provider switches relatively painless
New-build address recognised but service activation date is far in the futureSign for the new-build address with target activation date; use 4G or 5G bridge for the gapStandard scenario for new-build moves; works well with 12-month no-exit-fee tariffs

Practical advice for movers with existing broadband contracts. First, contact your existing retailer's move-home team (BT, Sky, Virgin Media, EE, TalkTalk, Vodafone, Plusnet, NOW Broadband all have dedicated move-home processes) and explain the new-build situation specifically. Ask whether the retailer will (a) pause your contract until the new address is recognised, (b) waive any ETF if service genuinely cannot be delivered to the new address, (c) apply your existing contract terms to the new address once it is recognised. Some retailers are accommodating for new-build moves; others are less flexible. Second, where the existing retailer is not flexible and the new-build address is taking a long time to become orderable, the practical answer may be to accept any reasonable ETF (or wait for contract end) and start fresh with a 12-month no-exit-fee tariff (Cuckoo, NOW Broadband 12-month) once the new address is genuinely available. Third, for move dates that are clearly known well in advance, engaging the existing retailer 4 to 6 weeks before move date with a clear new address allows them to coordinate the move-home process if the address is recognised in time.

Speculative ordering: the risk and how to avoid it

One of the most common UK new-build buyer mistakes is signing a 24-month broadband contract before the address is genuinely orderable, based on developer-supplied availability promises or partial postcode-level availability checks. This is "speculative ordering" and it can leave buyers paying for service that the provider cannot actually deliver.

How speculative ordering goes wrong:

How to avoid speculative ordering:

  1. Confirm exact-address availability with at least two retailers before signing. If BT, Sky, and your developer-partnered altnet all show the same address as orderable, the address is genuinely available. If only one retailer shows availability and others do not, wait for full sync before committing.
  2. Use 12-month no-exit-fee tariffs for the first year. Cuckoo, NOW Broadband 12-month, or rolling-month altnet options give you clean exit if the service does not behave as expected.
  3. Avoid 24-month commitments before the address is fully verified. Even if the address shows as available, waiting an extra 1 to 2 weeks to confirm consistent availability across multiple retailers is genuinely worthwhile.
  4. Use 4G or 5G bridges for the wait. Rolling-month bridges remove the urgency to sign fixed-line contracts speculatively; you can wait until the address is verified without being offline.
  5. Document availability evidence at the point of signing. Screenshot retailer checkers showing your address as orderable when you sign; if the provider later disputes availability, this evidence supports your position.

24-month contract cautions for new-build movers

UK broadband contracts in 2026 are typically available in 1-month rolling, 12-month, 18-month (Virgin Media standard), and 24-month forms. For most UK customers in stable established homes, 24-month contracts offer the best headline price. For new-build movers specifically, 24-month contracts have meaningful drawbacks during the first 12 months that warrant explicit consideration.

The structural drawbacks of 24-month contracts for new-build movers:

The practical contract recommendation for UK new-build movers in 2026. For the first 12 months in a new home, use 12-month no-exit-fee tariffs (Cuckoo, NOW Broadband 12-month) or rolling-month altnet options where available; this gives flexibility while the household pattern stabilises and any infrastructure issues are identified. After 12 months of stable service, switching to a 24-month contract with the same or different retailer for better headline pricing becomes reasonable; by this point you have verified the service quality, confirmed the speed tier matches your actual demand, and have stable expectations of provider reliability. This sequence costs slightly more in the first year (12-month tariffs are typically £2 to £5 per month more expensive than 24-month equivalents) but the flexibility is genuinely valuable for new-build movers.

Escalation routes: Ofcom, Communications Ombudsman, CISAS

Where standard routes (Get Connected form, developer engagement, retailer customer service) have not resolved a UK new-build broadband delay within reasonable timeframes, formal escalation routes are available. The right route depends on which party is causing the delay.

Issue type Right escalation route What they do
Provider has accepted contract but cannot deliver serviceCommunications Ombudsman or CISAS (Alternative Dispute Resolution providers)Independent dispute resolution; binding decisions on the provider; free for consumers
Provider customer service has been unresponsive for 8 plus weeksCommunications Ombudsman or CISAS once 8-week deadlock letter issuedSame as above; the 8-week deadlock is a procedural prerequisite
Systemic issues across many residents in same developmentOfcom (regulator) plus consider local press or MP engagementOfcom can investigate systemic issues; consumer complaints to Ofcom inform their regulatory work
Developer Part R compliance failuresLocal authority Building Control plus DSITBuilding Control assesses Part R compliance; DSIT oversees the regulatory framework
Council tax or other public-service registration not synced with new-buildLocal authority direct (council customer services)Local authority handles council tax and many public service address registrations
Disputes about provider charges or refundsCitizens Advice or Communications OmbudsmanCitizens Advice for guidance; Ombudsman for binding resolution

How the Communications Ombudsman process works. The Communications Ombudsman is one of two ADR (Alternative Dispute Resolution) providers approved by Ofcom for UK telecommunications disputes; the other is CISAS. Provider membership is mandatory; every UK broadband provider belongs to one or the other. To use the Communications Ombudsman: first, complete the provider's internal complaints procedure; second, request a "deadlock letter" or wait 8 weeks if not resolved; third, submit the complaint to the Communications Ombudsman. The Ombudsman investigates, makes a decision, and the provider is bound to comply. Free for consumers; typical resolution timeline 6 to 12 weeks. Available at commsombudsman.org.

How CISAS works. Functionally identical to the Communications Ombudsman; same procedural prerequisites (deadlock letter or 8-week wait); same independent decision-making process; same binding nature on providers. Available at cedr.com/consumer/cisas. Different providers belong to different ADR providers; check your provider's terms or the relevant ADR provider's website to confirm.

How Ofcom complaints work. Ofcom is the UK communications regulator, not a dispute resolution body for individual consumer cases. Ofcom does not adjudicate individual disputes; the Communications Ombudsman or CISAS does that. However, Ofcom does collect consumer complaints data which informs their regulatory work; reporting an issue to Ofcom is appropriate where the issue is systemic (affecting many consumers similarly) rather than specific to your individual case. Ofcom's complaint reporting form is at ofcom.org.uk; this is not a route for resolving your specific issue but is appropriate for ensuring the regulator is aware of patterns affecting UK new-build broadband delivery.

When to escalate vs continue waiting

Distinguishing between a normal handover gap (frustrating but proceeding through standard timelines) and an unreasonable delay (genuinely warranting escalation) is genuinely useful. Practical guidance:

Time since move-in Status Recommended action
0 to 4 weeksWithin normal handover gapUse 4G or 5G bridge; check progress weekly; complete Get Connected form if useful
4 to 8 weeksApproaching upper end of typical gapEngage developer customer care; complete Get Connected form if not done; check Royal Mail PAF status
8 to 12 weeksUpper end of typical gap; escalation appropriate if no clear progressEngage developer in writing; document responses; consider Citizens Advice consultation
12 to 16 weeksBeyond typical gap; investigation warrantedFormal complaint to developer; if no response, consider Communications Ombudsman; document everything
16 plus weeksMaterially beyond typical timelinesCommunications Ombudsman or CISAS escalation; Ofcom complaint for systemic issues; engage local authority Building Control on Part R compliance
Specific provider has accepted contract but cannot deliverProvider-specific issue regardless of total timeProvider's internal complaints procedure first; Communications Ombudsman after deadlock letter

Things to keep in mind during the wait:

Building Regulations Part R: the developer's compliance obligation

Building Regulations Part R (in force in England from 26 December 2022) is the regulatory framework requiring UK new-builds to be designed and built with gigabit-capable network infrastructure to the property by default where economically viable. For UK new-build buyers facing broadband delays, Part R provides specific consumer protection: the developer is legally obligated to deliver compliant broadband infrastructure unless specific exemptions apply.

The developer obligations under Part R relevant to broadband delays:

What this means for buyers experiencing delays. If broadband cabling and infrastructure was installed correctly during construction (the standard Part R-compliant scenario), the delay is a registration sequence issue not a compliance issue; standard escalation routes apply. If the developer cannot demonstrate that Part R-compliant infrastructure was actually installed at your home, this is a Part R compliance issue and the developer is legally obligated to remediate; engage local authority Building Control and the Department for Science, Innovation and Technology (DSIT) which oversees the regulatory framework. Most major UK developers are conscientious about Part R compliance because non-compliance has real legal and financial consequences; cases of genuine non-compliance are rare in 2026 but exist particularly for smaller developers or unusual sites.

How to verify Part R compliance at your specific home. First, ask the developer for documented evidence of broadband infrastructure installation and Building Control sign-off; reasonable developers can provide this. Second, physically check whether broadband infrastructure is visible at your home: most Part R-compliant new-builds have an Optical Network Terminal (ONT) installed somewhere in the property (often in the meter cupboard, hallway, utility room, or under the stairs) plus visible cabling routed to the street distribution point. Third, if the developer cannot provide documentation and physical infrastructure is not evident, contact your local authority Building Control to verify compliance status. Fourth, where compliance failures are confirmed, the developer is responsible for remediation; this may require retrofitting infrastructure post-completion which adds substantial time but is legally required.

Decision framework for your specific delay scenario

If you are 0 to 4 weeks in

  • This is normal handover gap territory; do not panic.
  • Set up a 4G or 5G bridge for working internet.
  • Complete the Openreach Get Connected form.
  • Check Royal Mail PAF status; check broadband checkers weekly.

If you are 4 to 12 weeks in

  • Approaching upper end of typical gap; engagement appropriate.
  • Engage developer customer care in writing using template.
  • Document all responses and checker screenshots.
  • Continue 4G or 5G bridge.

If you are 12 plus weeks in

  • Beyond typical timelines; investigation warranted.
  • Formal complaint to developer with specific questions.
  • If no clear progress, Communications Ombudsman or CISAS.
  • Consider local authority Building Control for Part R compliance check.

If a provider has charged you for service they cannot deliver

  • Provider's internal complaints procedure first.
  • Request "deadlock letter" or wait 8 weeks if not resolved.
  • Communications Ombudsman or CISAS for binding resolution.
  • Document all communications and charges.

Honest tie-break for new-build buyers stuck in delay

Check current availability at your new-build

See whether your new-build address is now orderable for FTTP, FTTC, cable, altnet, or 4G or 5G home broadband. Independent comparison from 35 plus UK retailers, refreshed multiple times daily.

Check availability at your postcode

Independent results; no signup required. Prices refresh multiple times daily.

Editorial accountability. This page was written by Adrian James (broadband editor at BroadbandSwitch.uk) and reviewed for accuracy by Dr Alex J. Martin-Smith (head of editorial). Building Regulations Part R guidance is sourced from UK Government published Building Regulations 2022 amendments (in force 26 December 2022), HM Government Approved Document R, and Department for Science, Innovation and Technology (DSIT) published guidance on gigabit-capable infrastructure for new-builds. Openreach process information including the "Get connected at a new development" form and the "Build It and Connect It" self-builder process is from Openreach published documentation at openreach.com/connecting-new-properties. Royal Mail Postcode Address File registration sequence is from Royal Mail published guidance for new address submission via the New Build Project team. Communications Ombudsman and CISAS escalation processes are from each ADR provider's published procedures at commsombudsman.org and cedr.com/consumer/cisas. Ofcom regulatory framework guidance is from Ofcom published guidance on telecommunications consumer rights. 4G and 5G home broadband bridge options are from Three Home, EE Home, Vodafone, O2, Smarty, and other UK operator published service descriptions for 2026. Where 2026 figures or provider tariffs may change after publication, that is signalled in the prose; we recommend confirming any specific tariff or escalation process with the named party directly before proceeding. We never accept payment from providers in exchange for editorial coverage; full affiliate disclosure is on our affiliate disclosure page. This page was last updated on 26 April 2026; the next review is within 90 days.

New-build broadband delay FAQs

Why does my postcode show service but my exact address does not?

Because broadband checkers operate at the exact-address level, not the postcode level. A postcode in the UK can cover anywhere from a single building to hundreds of properties, and within any postcode some addresses may be fully registered and orderable while others (typically newer additions like new-builds) are not yet in the providers' databases. Three common reasons your specific address may not be recognised even when the postcode shows service. First, your address has not yet been registered with Royal Mail's Postcode Address File (PAF) by the developer; check directly at royalmail.com. Second, your address is in PAF but has not yet synced into the network operator's database (Openreach, Virgin Media, or your developer-partnered altnet); operators typically pick up new PAF entries within 1 to 4 weeks of Royal Mail registration. Third, you may be checking using the plot address (construction-phase identifier like 'Plot 47, Phase 2') rather than the final postal address ('32 Beech Avenue, Newtown'); broadband checkers cannot find plot addresses. Use the postal address. Practical sequence: confirm your postal address with the developer; check it on Royal Mail's PAF finder; if registered, complete the Openreach Get Connected form to expedite operator commissioning; if 4 to 8 weeks pass without progress, engage the developer's customer care team in writing.

How long should I expect to wait before my new-build address goes live for broadband?

Typically 4 to 12 weeks from your physical move-in date for fixed-line broadband. This is the cumulative time for the registration sequence to complete: Royal Mail PAF registration (1 to 4 weeks); network operator commissioning (1 to 4 weeks after PAF); retailer database sync (a few days to 2 weeks after commissioning). Some addresses go live faster (especially in developments with strong developer-Openreach coordination); occasionally addresses take longer (smaller developments, rural new-builds, or developments where operator commissioning has been deprioritised). Building Regulations Part R (in force 26 December 2022) requires UK new-builds to be designed and built with full fibre infrastructure to the property by default; this means most UK new-builds since December 2022 have FTTP cabling already in place at handover, but the connection records that allow broadband providers to take orders are still sequential post-handover steps. The practical advice is to plan a 4G or 5G home broadband bridge (Three 5G Hub, EE 5G Smart Hub Plus, Vodafone GigaCube, O2 Home Wireless on rolling 1-month) for the first 4 to 12 weeks, completing the Openreach Get Connected form to potentially expedite the process. If 12 plus weeks pass without progress, engage the developer's customer care team in writing using the template provided in this guide; consider escalation to the Communications Ombudsman or CISAS after 16 weeks.

What is the Openreach "Get connected at a new development" form?

The Openreach "Get connected at a new development" form is a customer-facing tool at openreach.com/connecting-new-properties that allows UK new-build residents to directly engage Openreach about broadband availability at their specific address. It is the single most useful single tool for residents whose address is not yet orderable through retailers, because rather than waiting passively for the standard sync sequence to complete, the form raises a specific case at Openreach for your address. How to use it effectively: use your final postal address (not plot address); provide the developer's name and the development name (Openreach uses these to cross-reference with their existing developer relationships); state your move-in date so Openreach can prioritise your case; note any specific stage you have identified as the blocker (PAF registration, operator commissioning, retailer sync); provide a working contact phone number and email. What Openreach typically does in response: for straightforward cases, Openreach acknowledges and the address typically appears in retailer systems within 1 to 2 weeks of form submission; for cases with specific commissioning blockers, Openreach engages with the developer or internal teams to resolve and provides updates; for cases that have been waiting unreasonably long, Openreach typically prioritises and provides an expected resolution date. The form is also useful for residents stuck on FTTC where FTTP should be available under Part R; it prompts Openreach to verify FTTP infrastructure status at your specific address.

Can the developer fix a broadband delay at my new-build?

It depends on the type of delay. Developers can directly fix delays caused by Royal Mail PAF registration issues (the developer is the party that submits postal addresses to Royal Mail's New Build Project team; if the submission has not happened or is delayed, the developer is the right party to fix this) and developer-operator coordination issues (some commissioning delays trace back to developers not yet confirming completion of specific plots to the operator, or specific configuration details not yet provided). Developers cannot meaningfully expedite Openreach's standard 1 to 4 week commissioning timeline post-PAF registration; the Openreach Get Connected form is the more useful single tool for that stage. Developers also cannot fix retailer database sync delays because the developer has no direct involvement once Openreach has commissioned the address. Most major UK developers (Persimmon, Taylor Wimpey, Barratt Redrow, Bellway, Berkeley Group, Crest Nicholson, Vistry, Bloor) have customer care teams that handle post-completion broadband concerns; smaller developers may have less developed support. The practical advice: engage the developer's customer care in writing with specific factual questions (when was the postal address submitted to Royal Mail; is the development fully handed over to Openreach; has the developer confirmed completion of your plot to the operator; which broadband providers has the developer partnered with; has Part R compliance been verified); allow 14 working days for response; document all correspondence. Reasonable developers respond constructively because broadband is a genuine quality-of-life issue and developers want their owners to have working homes.

What is the best short-term broadband option while waiting for fixed-line?

4G or 5G home broadband on rolling 1-month terms is the strongest UK option for new-build delays. The 2026 options: Three Home 5G Hub on rolling 1-month delivers 100 to 300 Mbps in strong-signal urban areas with the strongest UK 5G coverage in major cities; EE 5G Smart Hub Plus on rolling 1-month delivers 100 to 500 Mbps with excellent 5G coverage; Vodafone GigaCube on rolling 1-month or 24-month delivers 50 to 200 Mbps and is available for both 4G and 5G; O2 Home Wireless on rolling delivers 50 to 300 Mbps in 5G areas, useful where Three or EE 5G coverage is weak. Cheaper alternative for very short bridges or single-tenant scenarios: a Smarty unlimited data SIM plus portable hotspot device or smartphone tethering can carry a single tenant or couple adequately for 2 to 4 week bridges at £15 to £25 per month. Practical sequence: check 5G coverage at your specific new-build address using each operator's coverage checker before ordering (coverage varies significantly by location even within the same town because new-build estates may have weaker signal than older houses 500 metres away); order the 5G Hub or equivalent; set up on arrival and verify signal strength in your primary internet-use room; cancel the rolling plan once fixed-line FTTP is fully tested and active. Typical bridge cost £25 to £40 per month for major 5G Hubs; cumulative cost for typical 4 to 12 week handover gap is £25 to £120 which is a modest insurance against being offline. For households with home workers, online learners, or smart-home dependence, the cost is genuinely worthwhile.

When should I escalate a new-build broadband delay to Ofcom or the Ombudsman?

Escalation is appropriate when standard routes have not resolved the delay within reasonable timeframes. Practical guidance. At 0 to 4 weeks after move-in, this is normal handover gap territory; do not panic; use a 4G or 5G bridge and complete the Openreach Get Connected form. At 4 to 8 weeks, approaching upper end of typical gap; engage developer customer care; check Royal Mail PAF status. At 8 to 12 weeks, escalation appropriate if no clear progress; engage the developer in writing with specific questions; document all responses. At 12 to 16 weeks, formal complaint to developer; if no response, consider Communications Ombudsman or CISAS. At 16 plus weeks, materially beyond typical timelines; Communications Ombudsman or CISAS escalation; consider Ofcom complaint for systemic issues affecting multiple residents in the same development; engage local authority Building Control for Part R compliance check. The Communications Ombudsman and CISAS handle individual disputes; Ofcom is the regulator and does not adjudicate individual cases but does collect consumer complaints data informing regulatory work. Process for ADR escalation: complete the provider's internal complaints procedure first; request a "deadlock letter" or wait 8 weeks if not resolved; submit to the Communications Ombudsman at commsombudsman.org or CISAS at cedr.com/consumer/cisas. Free for consumers; typical resolution timeline 6 to 12 weeks; binding decisions on the provider. Document everything from the start of any delay; cumulative documentation is what matters for ADR decisions.

Should I order broadband as soon as my address shows in checkers, or wait?

Confirm exact-address availability with at least two retailers before signing any contract. If BT, Sky, your developer-partnered altnet, and other retailers all show the same address as orderable, the address is genuinely available. If only one retailer shows availability and others do not, wait a few more days for full sync; the address may have just been commissioned and is propagating through retailer databases. When availability is confirmed across multiple retailers, ordering is reasonable. Best practice for new-build movers: use 12-month no-exit-fee tariffs (Cuckoo, NOW Broadband 12-month) or rolling-month altnet options for the first year; this gives flexibility while the household pattern stabilises and any infrastructure issues are identified. Avoid 24-month commitments before the address is fully verified across multiple retailers. Avoid speculative ordering (signing a contract based on developer-supplied availability promises before retailers actually show the address as orderable); this can leave you paying for service that providers cannot deliver. Even with confirmed availability, 12-month no-exit-fee tariffs are typically £2 to £5 per month more expensive than 24-month equivalents, but the flexibility is genuinely valuable for new-build movers because actual service quality at your specific home (peak-time speeds, Wi-Fi coverage, latency, reliability) is only verifiable after install. Some new-build infrastructure issues only emerge after a few weeks of real use; clean exit options matter. Use the period before your address is confirmed orderable to keep researching: which providers will eventually serve the address; which speed tier matches your actual demand; which contract length matches your circumstances. Plan your eventual order so it can move quickly once availability is confirmed.

What if Openreach FTTP is unavailable but FTTC is showing at my new-build?

Most UK new-builds since December 2022 should have FTTP under Building Regulations Part R, so FTTC-only availability at a new-build is unusual and warrants investigation. Three possibilities. First, Openreach FTTP commissioning has been deprioritised or missed despite the developer having installed the infrastructure; complete the Openreach "Get connected at a new development" form at openreach.com/connecting-new-properties to prompt Openreach to verify FTTP status at your specific address. Often the FTTP infrastructure is in place but has not been added to the wholesale ordering database; the form prompts the missing step. Second, the development may have been completed before Part R came into force on 26 December 2022, or may be subject to a Part R exemption; check with the developer when the development was approved by Building Control. Third, the development may be in an area where Openreach FTTP is genuinely unavailable within the £2,000 per dwelling cost cap; this is rare in serviced urban areas but possible in some rural locations. Practical actions: complete the Get Connected form; ask the developer specifically about Part R compliance and FTTP infrastructure installation; check whether your developer has any altnet partnership that provides FTTP via a different network; if FTTP is genuinely unavailable, FTTC is workable for many household demand profiles (50 to 80 Mbps download is enough for typical single-tenant or couple homes), or 4G/5G home broadband can deliver speeds matching or exceeding FTTC in strong-signal urban areas; if Part R compliance failures are suspected, engage local authority Building Control and the Department for Science, Innovation and Technology (DSIT) which oversees the regulatory framework.

References

1. Building Regulations Part R, DSIT new-build infrastructure guidance, and Openreach process documentation

UK Government (2022). Building Regulations 2022 amendments including Part R (in force 26 December 2022) requiring UK new-builds to be designed and built with gigabit-capable network infrastructure to the property by default where economically viable. Plus HM Government Approved Document R guidance and Department for Science, Innovation and Technology (DSIT, 2026) published guidance on gigabit-capable infrastructure for new-builds. Plus Openreach (2026) "Get connected at a new development" and "Build It and Connect It" published process documentation at openreach.com/connecting-new-properties.

openreach.com/connecting-new-properties

2. Royal Mail PAF registration and Communications Ombudsman/CISAS escalation processes

Royal Mail (2026) Postcode Address File (PAF) New Build Project team registration sequence and typical 1 to 4 week processing timelines. Plus Communications Ombudsman (2026) published procedures at commsombudsman.org for telecommunications dispute resolution including the 8-week deadlock requirement and binding decision process. Plus CISAS (Centre for Effective Dispute Resolution Communications and Internet Services Adjudication Scheme, 2026) published procedures at cedr.com/consumer/cisas.

commsombudsman.org

3. 4G and 5G home broadband and Ofcom regulatory framework

Three Home, EE Home, Vodafone, O2, and Smarty (2026) published service descriptions for 4G and 5G home broadband products available on rolling 1-month terms. Plus Ofcom (2026) published guidance on telecommunications consumer rights including the in-contract price rise rule effective 17 January 2025 and consumer complaint procedures. Plus Citizens Advice published guidance on UK new-build buyer rights and broadband-specific consumer concerns.

ofcom.org.uk

Final step

Check current availability at your new-build address

FTTP, FTTC, cable, altnet partnerships, and 4G or 5G home broadband: see the live status at your specific plot with current pricing from 35 plus UK retailers.

Compare broadband at your postcode

Last reviewed: 26 April 2026
